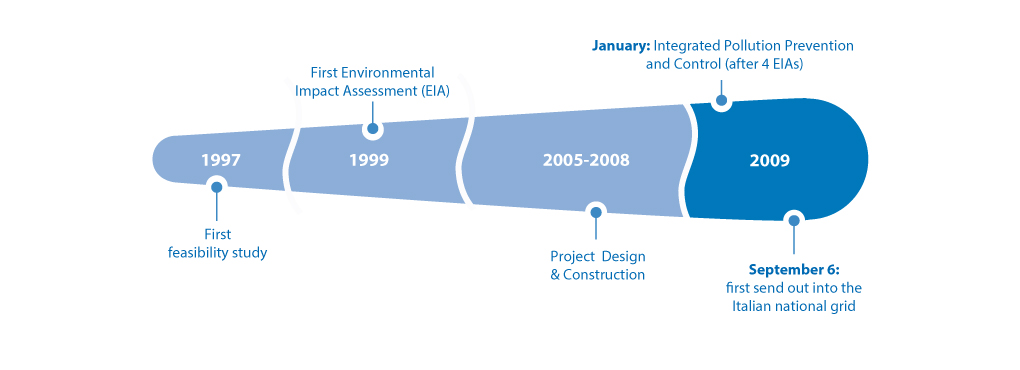

Construction

The terminal became operational in 2009, after a long phase of construction and startup, which took place mainly in the shipyard of the basin of Campamento, at Algeciras, in southern Spain.

adriaticlng_terminale_costruzione

May 2005 Construction of the GBS begins at Algeciras, Spain

May 2005 Construction of the GBS begins at Algeciras, Spain

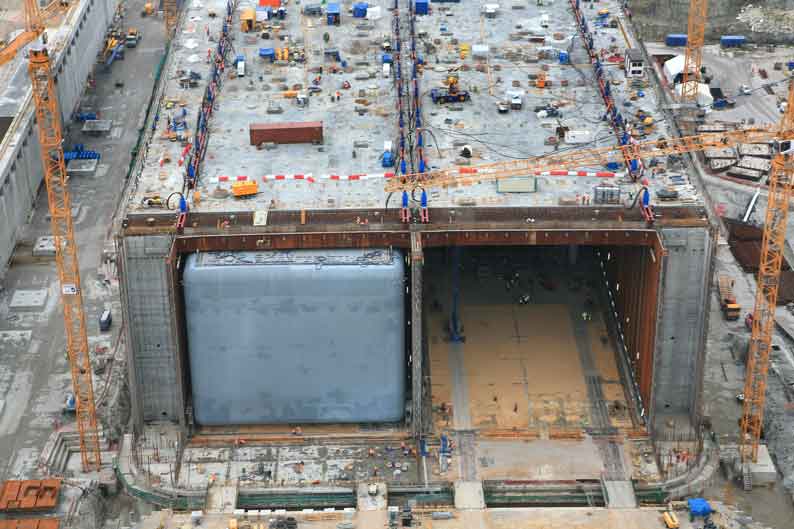

March 2007 LNG storage tanks are installed in the GBS

March 2007 LNG storage tanks are installed in the GBS

July 2007 The GBS structure is completed

July 2007 The GBS structure is completed

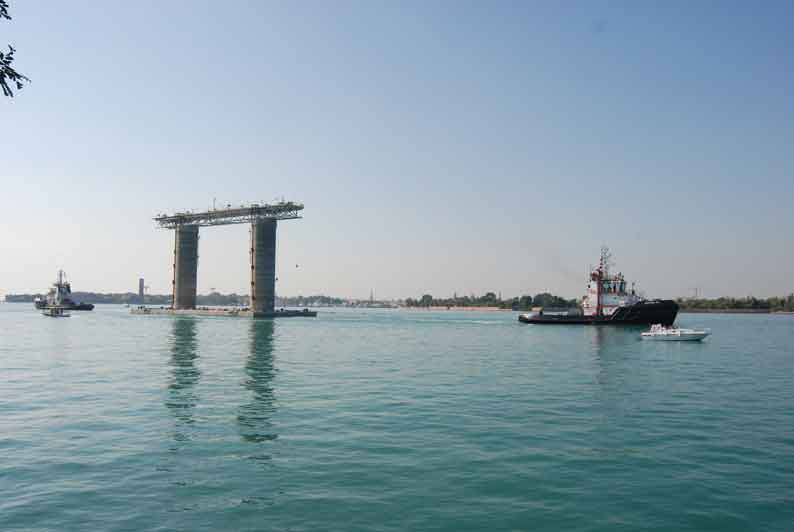

August 2008 The GBS leaves Spain, towed by four large ocean tugs to reach its final destination off the Veneto coast

August 2008 The GBS leaves Spain, towed by four large ocean tugs to reach its final destination off the Veneto coast

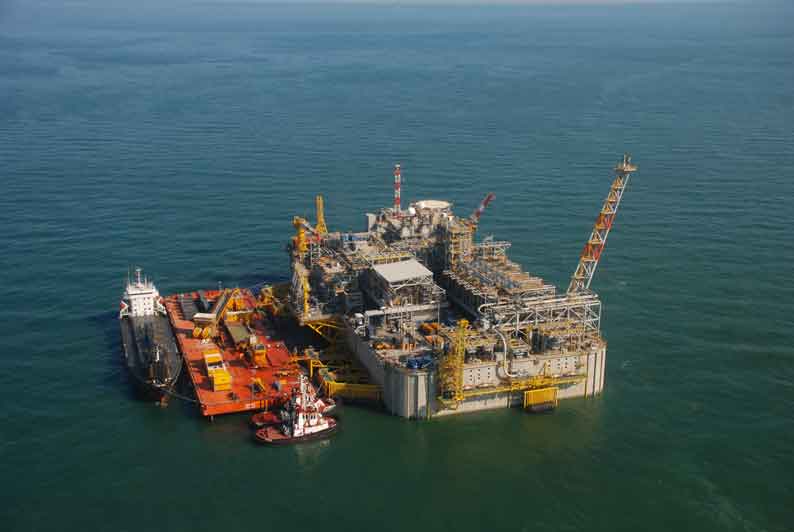

September 2008 The terminal enters its final hook-up and commissioning phase

September 2008 The terminal enters its final hook-up and commissioning phase

October 2008 Berthing facilities (so called "Mooring Dolphins") leave the Arsenale shipyard in Venice to reach the terminal for installation

October 2008 Berthing facilities (so called "Mooring Dolphins") leave the Arsenale shipyard in Venice to reach the terminal for installation

10 August 2009 The first cargo of Qatar LNG delivered for cooling the tanks and processing plant

10 August 2009 The first cargo of Qatar LNG delivered for cooling the tanks and processing plant

 6 September 2009 First gas sent out from Adriatic LNG terminal to Italian national gas network

6 September 2009 First gas sent out from Adriatic LNG terminal to Italian national gas network
